Algorithm: Finding a MST of with edge-costs given by
Running time is where is number of vertices, edges respectively
- while loop runs times
- Inside each while loop we need to check of adding current edge creates a cycle time
Correctness of Kruskal’s algorithm
Assumption : All edge costs are distinct
Theorem

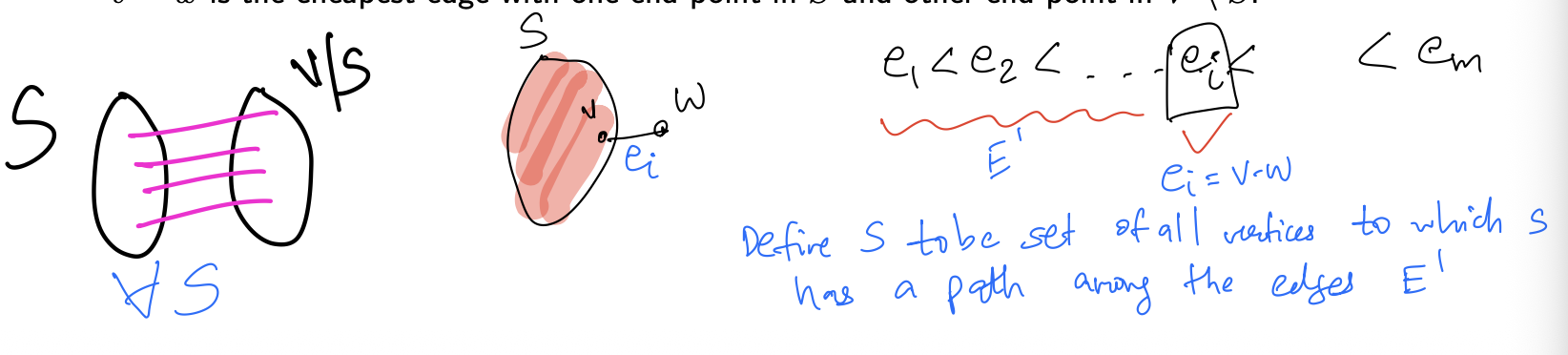

For any , let be the edge of minimum cost having one end-point in and other end-point in . Then, every MST contains the edge
- Suppose Kruskal’s algorithm adds the edge at this step.
- Let be set of all vertices to which had a path before this step.
- Clearly
- Before this step, by definition of , no edges from to have been added
- Since and and Kruskal’s algorithm adds edges in increasing order of costs, it follows that is the cheapest edge with one end-point in and other end-point in .
